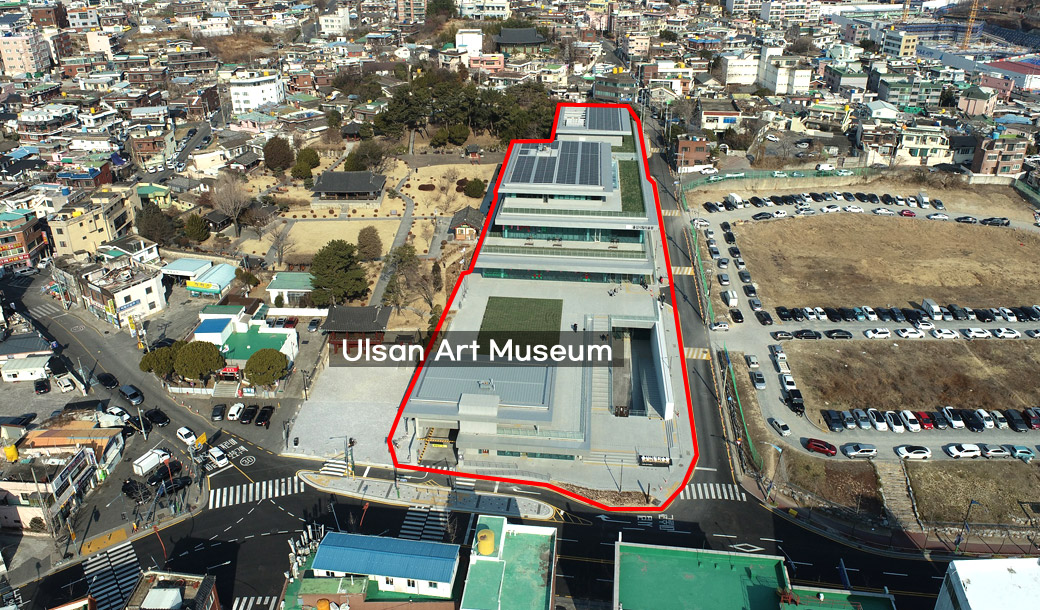

Project History

Aug 2011
Decision made to build a city art museum
Sep 2012
The site of Ulsan Art Museum decided
Oct 2012
A basic plan was established for the construction of the museum through a contractor
Jul 2013
Performed a feasibility study for the construction of the museum through a contractor
Mar 2014.
Approved the relocation of Ulsan Elementary School and an approval of Central Investment Loan
Apr 2014.
Paid compensation for the former Ulsan Elementary School building
May 2014.
Commenced demolition of the former Ulsan Elementary School
Jul 2014.
Conducted an excavation survey for buried cultural assets on the site of the former Ulsan Elementary School
Jul 2015.
Passed the Cultural Heritage Administration's deliberation on the plan to preserve the remains on the Ulsan Art Museum site
Aug 2015.
Reviewed the museum construction site
Feb 2016.
Held the Ulsan Art Museum Construction Advisory Committee meeting and collected opinions from the Jung-gu market merchants
Jun 2016.
Held the Ulsan Art Museum Construction Advisory Committee meeting and the Coordination Committee meeting due to the change of the construction site
Jul 2016.
Confirmed the museum construction site (Bukjeong Park + Jungbu Public Library)
Jul 2016.
Announced the public design competition for the 2nd phase of the construction of Ulsan Art Museum
Sep 2016.
Examined the public design contest for the 1st phase of the construction of Ulsan Art Museum (selected 5 designs)
Oct 2016.
Deliberated on the change of the shared property management plan due to partial changes to the museum construction site
Dec 2016.
Selected the final winner through the design competition screening for the 2nd phase construction of Ulsan Art Museum
Dec 2016.
Signed a contract for basic and working design for the construction of Ulsan Art Museum
Jul 2017.
Commenced a contract for basic and working design for the construction of Ulsan Art Museum
Mar 24, 2017.
Contracted and initiated construction project management services, such as acting as a supervision agency for the museum construction (until Feb 2020)
Aug 11, 2017.
Paid compensation for the land, buildings, and relocation of Jungbu Public Library (KRW 7.7 billion)
Dec 11, 2017.
Demolished the Jungbu Public Library and relocated obstructive objects at Bukjeong Park
Mar 27, 2018.
Completed the working design plan through a contractor
Apr 2, 2018.
Requested a construction order (procurement order)
Jul – Aug 2018.
Postponed construction orders and encouraged public discussions
Sep 2018.
Announced the results of the public discussions and resumed the construction
Oct – Dec 2018.
Adjusted the design specifications reflecting the prices in the second half of 2018
Jan – Jul 2019.
Procured order through Public Procurement Service, and selected the builder
Aug 2019.
Began with the construction

Promotion plan

Aug 2019 – nov 2021.
Started the construction work for the art museum
Nov 2021.
Completion of the art museum
Nov 2021. – Jan 2022.
Conducted a demonstrative operation of the museum, and opened the museum in January
